JANUARY 31, 2025
This Week:
The grader placed stone in the courtyard and the fire-main water line that had a small leak.
The HVAC crew completed their duct building at the shop and brought it all to the project to begin building the upper-level systems.
The electricians worked on the lighting wiring and controls.
The glass company installed the store front framing in their exterior openings.

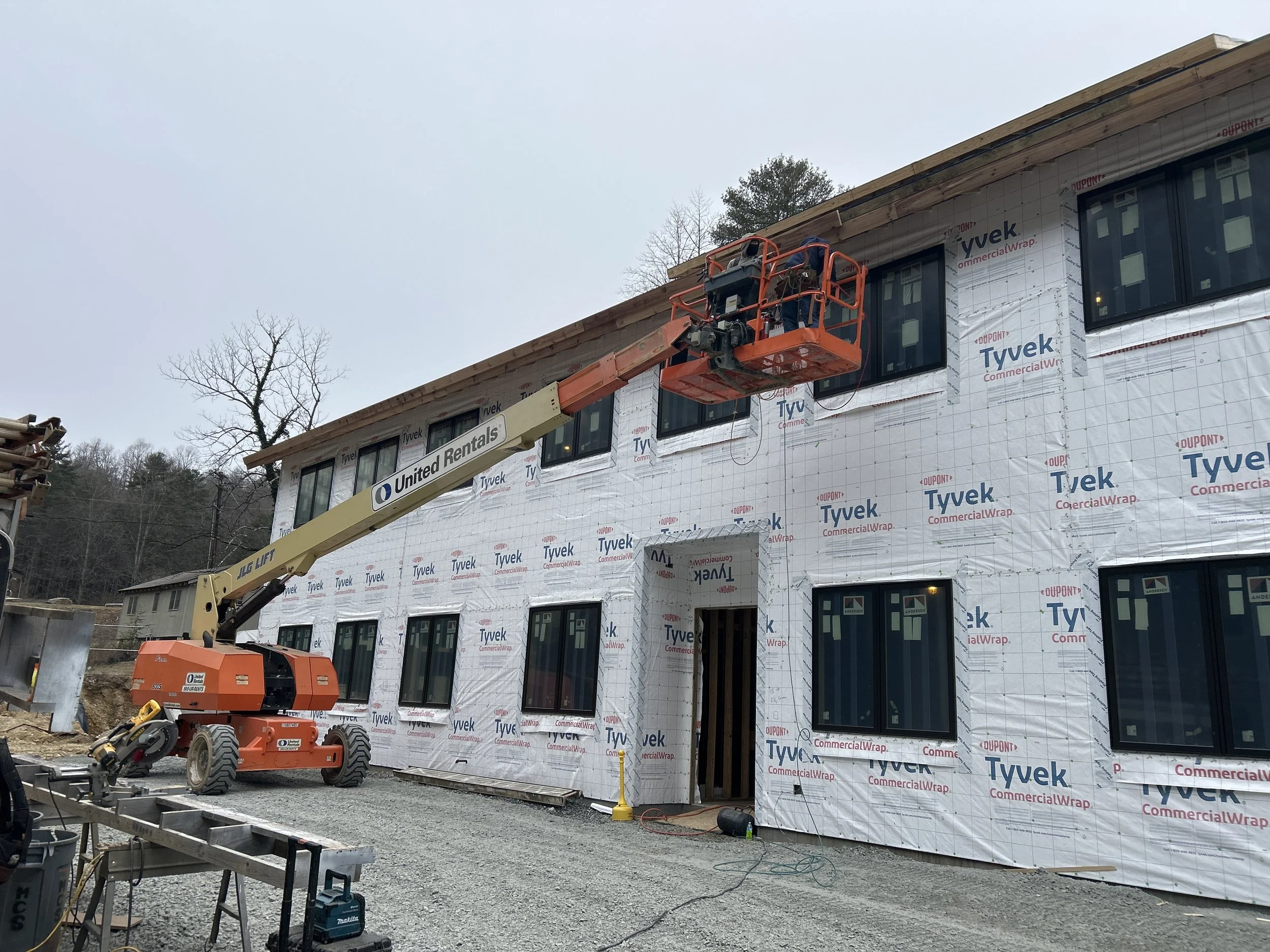

The fascia was completed by the siding contractor.
The roofers delivered their shingles midweek and began installation.
Upcoming:

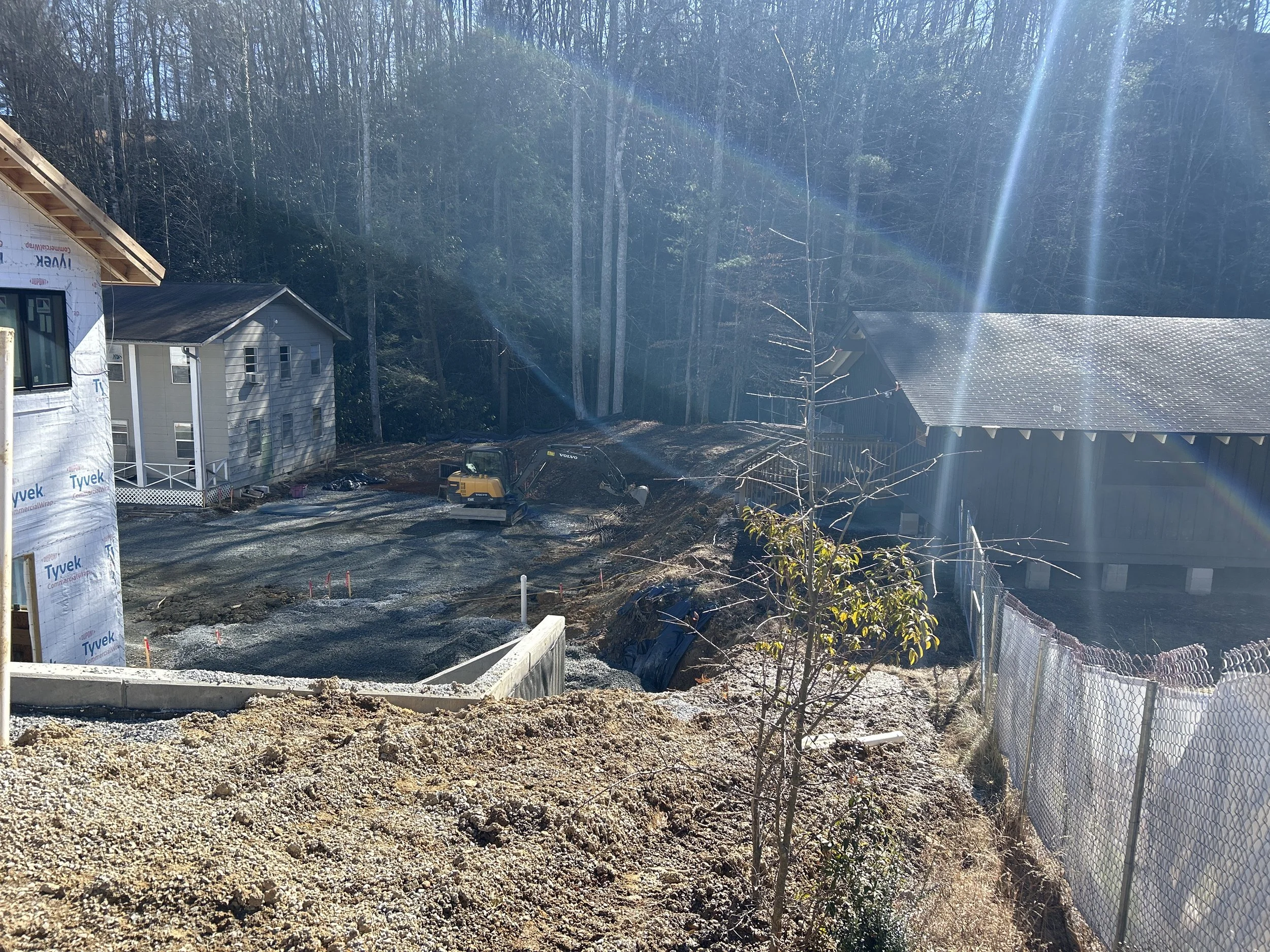

The grader will work on the downspouts and setting up the curb grades.
The HVAC and electrical rough-in will continue.
The shingle work on the roof will be completed.
JANUARY 24, 2025
This Week:
The siding contractor installed the fascia.
The sprinkler contractor fixed their drops for the drywall ceiling areas.
The HVAC crew worked on the exhaust fan ducts and supply registers in the drywall ceilings.
Upcoming:
The fascia installation will be finished.
The roofing will be installed.
The HVAC and electrical rough-in will continue.
JANUARY 17, 2025
This Week:

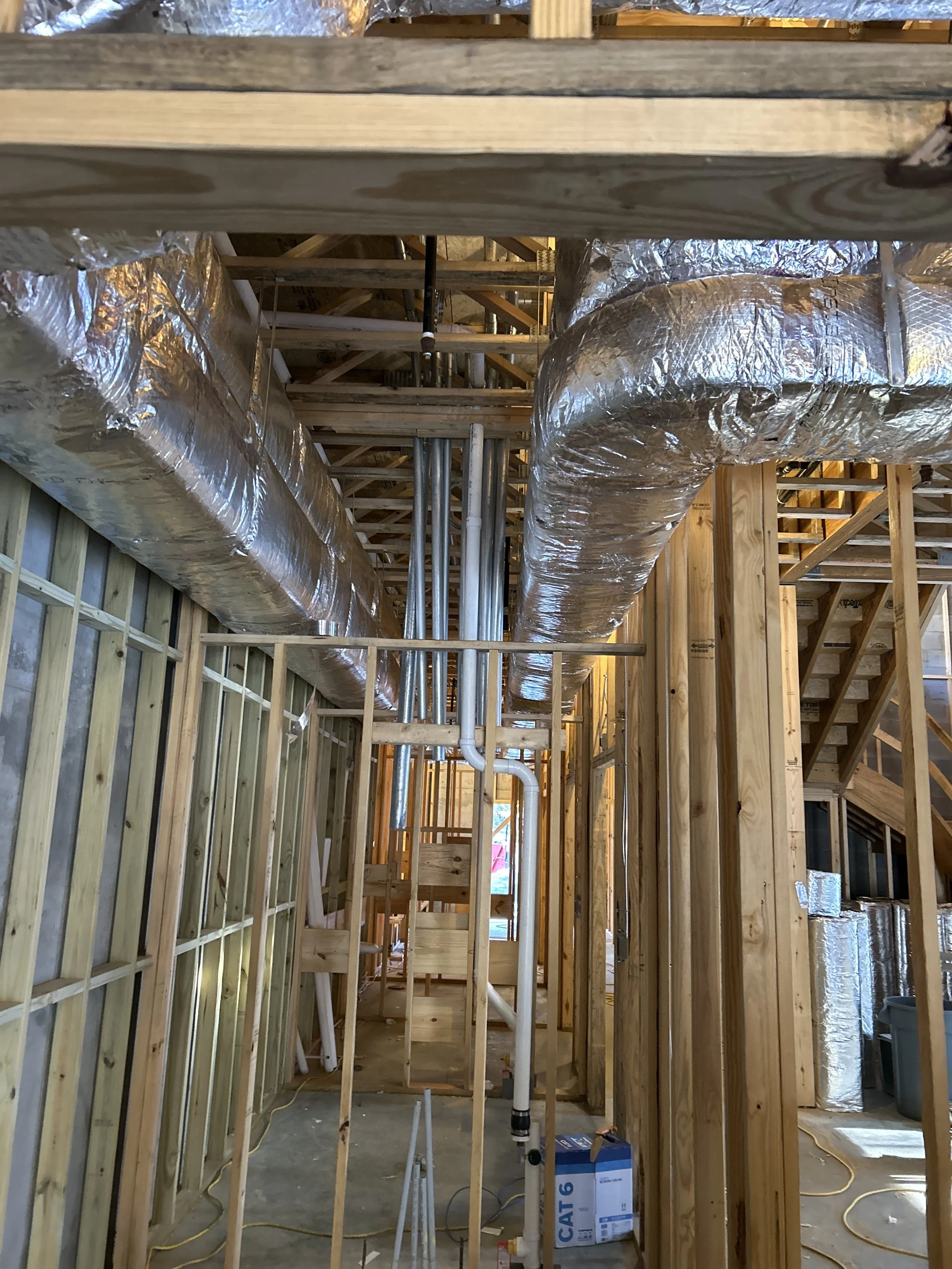

The HVAC crew worked on the lower-level branch lines and fresh air ducts.

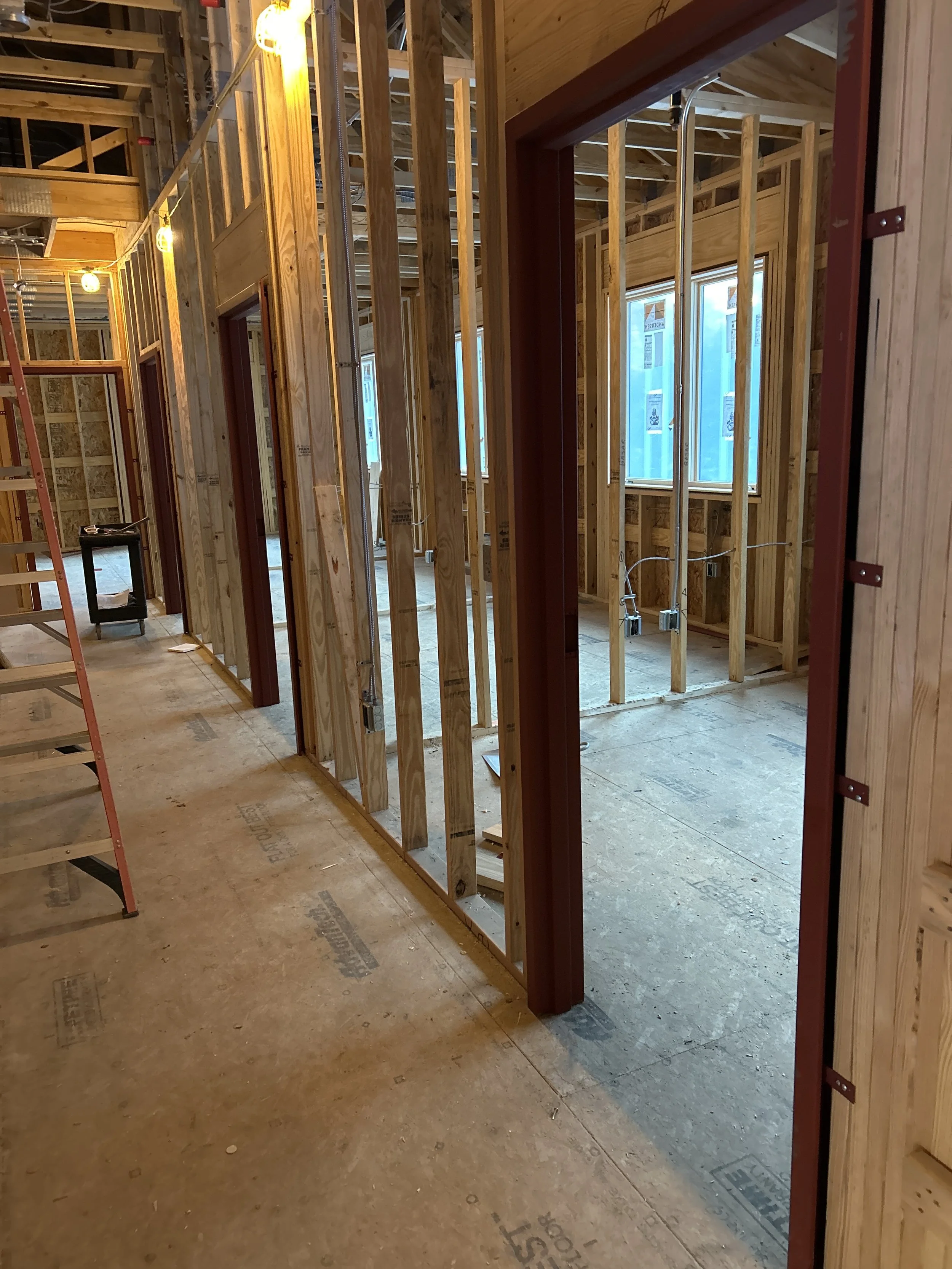

The door frame installation began and the contractor finished installing the upper-level and lower-level frames.
The framers installed the dropped ceiling framing and soffits in the meeting room.
The graders completed the sewer line for the building and installed a drain box for the gutter drains.
Upcoming:
The HVAC and electrical rough-in will continue.
The gas piping will be installed for the six furnaces.
The grader will continue working on the gutter drains and other utilities in preparation for the curb.
JANUARY 10, 2025
This Week:
The HVAC rough-in continued. They finished the main ductwork for the lower level systems.
The electricians continued running the conduit and began pulling wire.
The grader worked on the sewer lines for Harmony Hall and Dean's house.
The sprinkler system rough-in continued.
Upcoming:
The HVAC, electrical, and sprinkler rough-in will continue.
The framers will begin installing the soffit and fascia.
The grader will complete the utilities and prep for the curbing.
JANUARY 3, 2025
This Week:
The HVAC contractors ran the main trunks for the two systems on the lower level.
The sprinkler rough-in continued.
The pipe insulation began.
The grader backfilled the retaining wall and ran some of the gutter drains.
Upcoming:
The HVAC and sprinkler work will continue.
The electricians will continue the electrical rough-in.
The door frame installation will begin.
