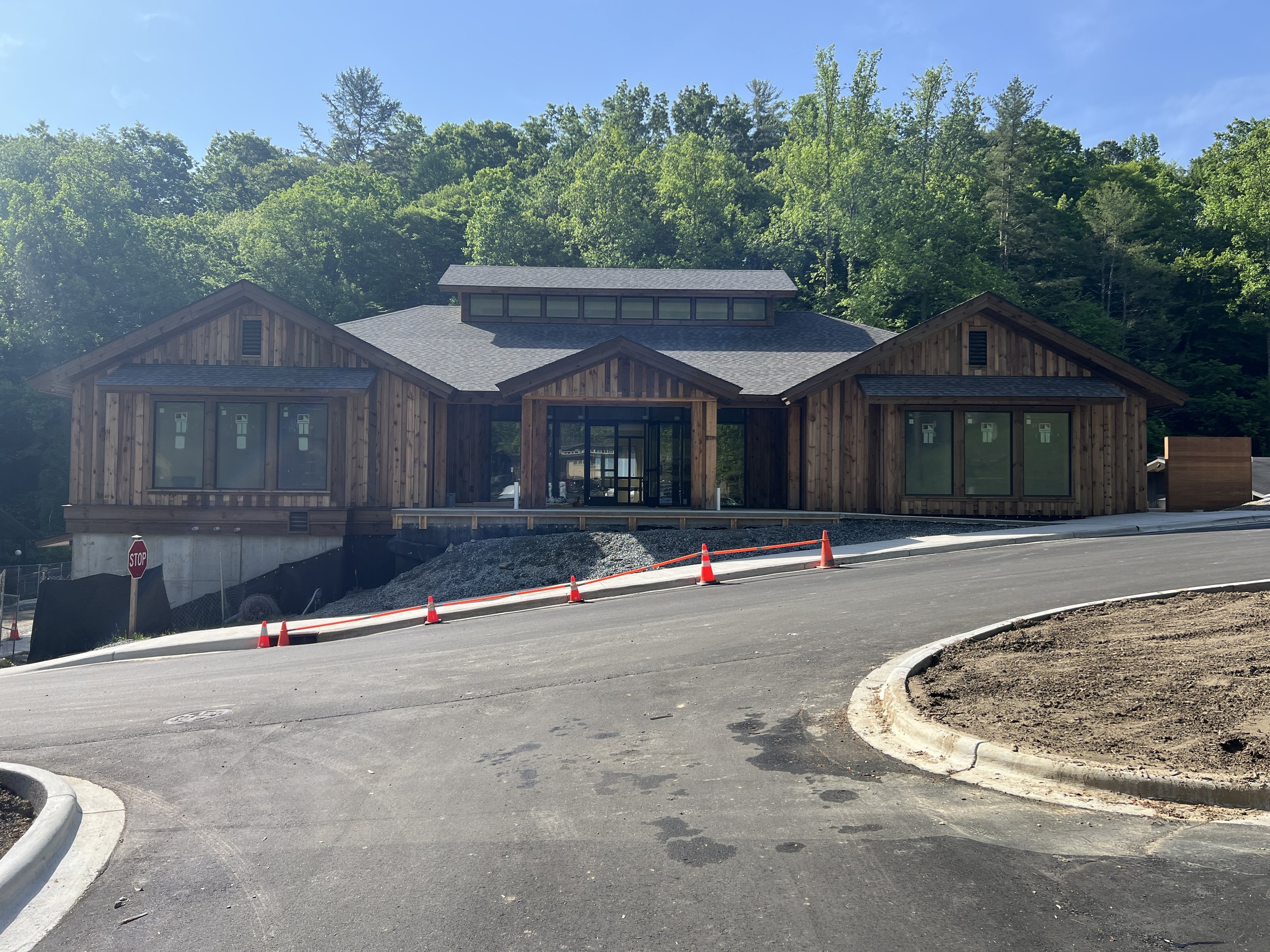

MAY 30, 2025
This Week:
The electricians worked on the elevator, the service entrance, and the lighting.
The trim carpenters continued installing the entry lobby plywood and trims.
The painters painted the metal door frames and primed and prepped the windows.
The drywall contractor installed drywall around the elevator door openings and patched throughout the building. They also installed the cut tile borders for the acoustical ceilings.
The pathway to Probart Street was graded. The grader placed and compacted stone for the paving.
The HVAC contractor installed thermostats and tied the line sets together.
Upcoming:
The electrical trims will continue.
The drywall install will finish.
The above ceiling will be inspected, so the acoustical tiles can be installed.
The trim carpenters will finish the lobby entry and will begin working on the lower-level wood.
The elevator installation will continue.
The grader will continue working on the path and will pave the currently unpaved section of the road.
MAY 23, 2025
This Week:
The electricians pulled the main service cables.
The elevator cab was constructed.
The trim carpenters installed the maple plywood.
The grader prepped the parking area, and it was paved on Thursday.
The stone masons began.

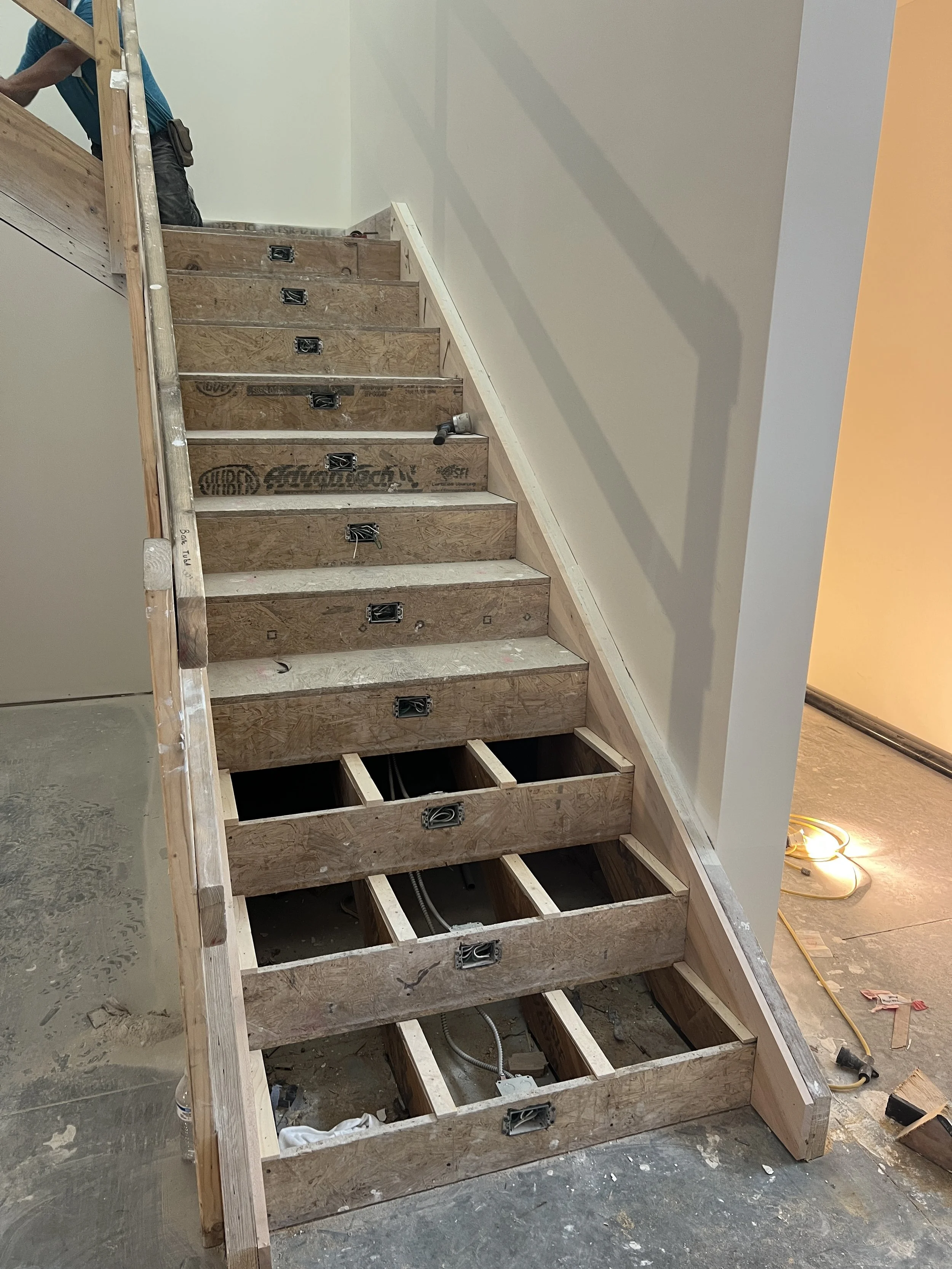

The two sets of stairs for the building were poured.
Upcoming:
The parking lot will be striped.
The stone masonry will continue.
The electrical trims and panel work will continue.
We will measure for the railings and get those into fabrication.
The interior trim work will continue.

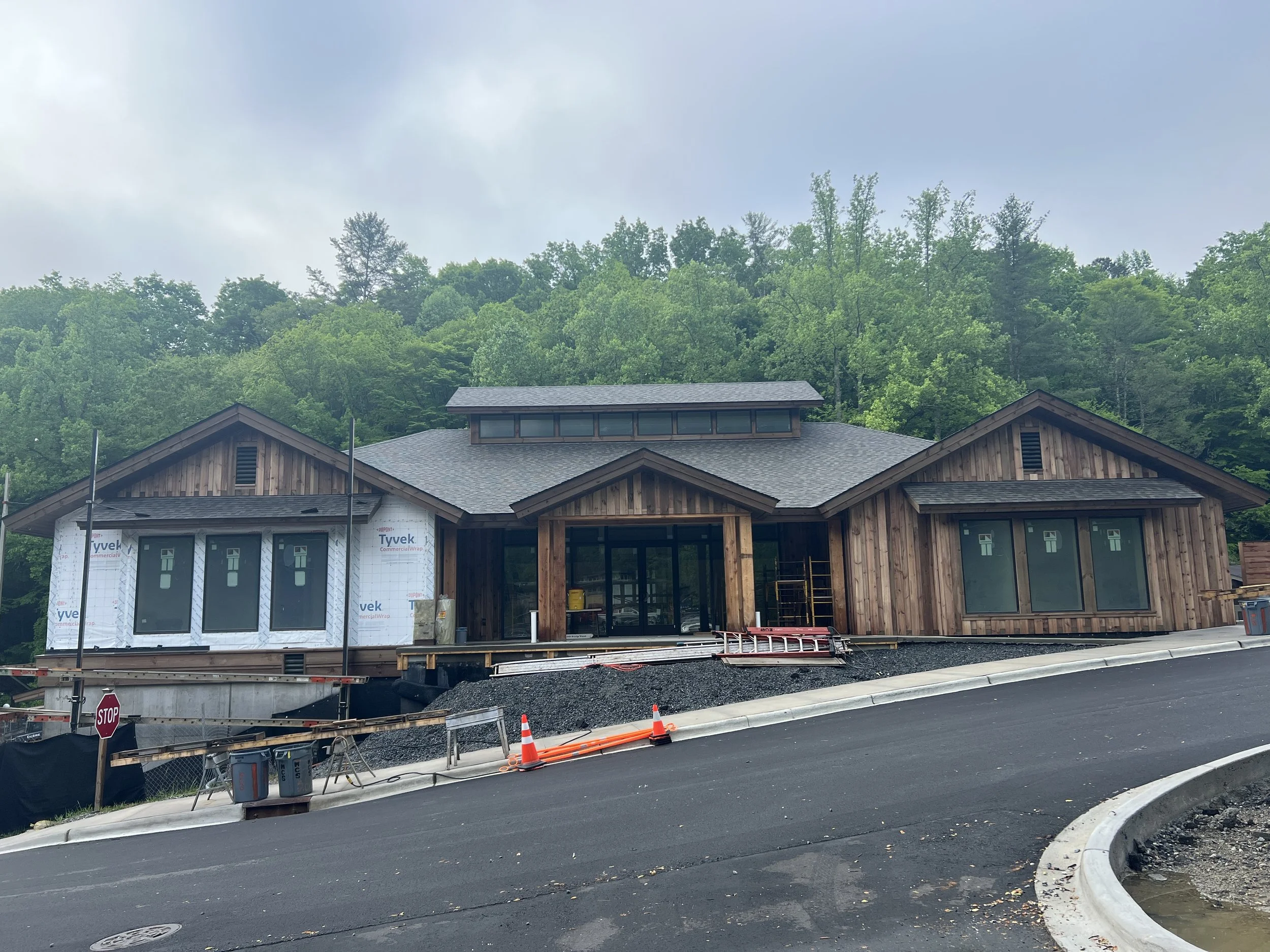

MAY 16, 2025
This Week:
The carpenters finished the exterior siding.
The trim carpenters continued framing out the areas and reviving the maple paneling.
The elevator rough-in was finished, and the block masons began infilling the elevator door frames.
The floors were installed in all of the bathrooms, and the wall tile was installed.
The solar system was installed.
The electricians continued to trim out and prep for permanent power.
The final section of curbing was poured.
Upcoming:
The grader will prep the site for the asphalt and sidewalk.

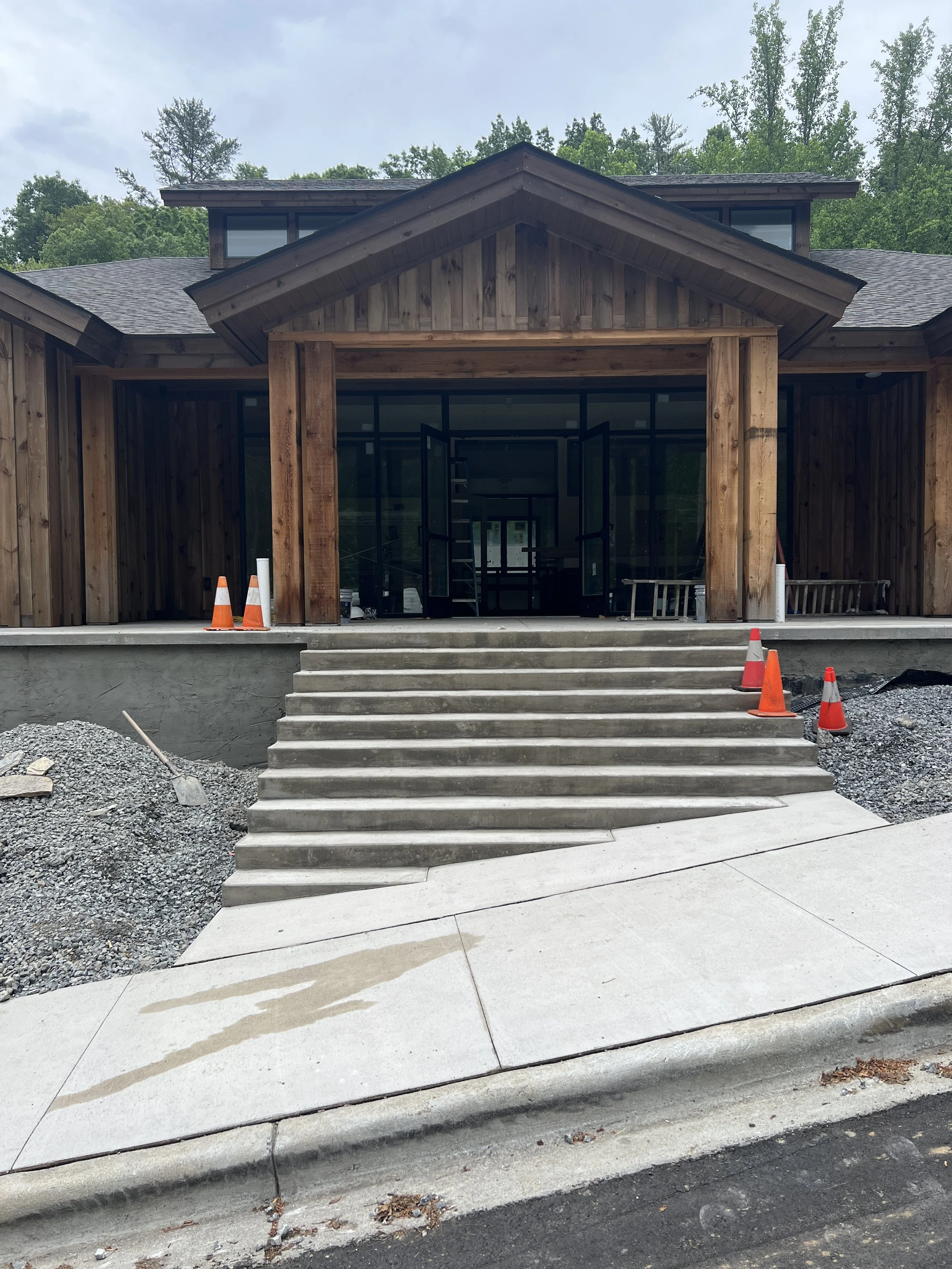

The concrete sub will form and pour the exterior steps.
The electricians will continue to trim out and pull the main power feeds to the panels.
The block masons will finish the elevator infill work.
The exterior stone work will begin on the foundation.
MAY 9, 2025
This Week:
The siding continued.
The electricians continued working on their trim outs and the service entry.
The carpenters installed framing for the wood and door trims.
The low-voltage contractor worked on their rack and trims.
The mason built a drainage box, and the grader installed the drainage pipe.
The fire alarm cable pulling began.
The elevator crew worked on their wiring and platform installation.
Upcoming:
The siding will be completed.
The elevator, electrical, and fire alarm installation will continue.
The bathroom floors and hard tile will be installed.
The carpentry will continue.
MAY 2, 2025
This Week:
The elevator contractor began installing the elevator.
The siding contractor continued the siding installation.
The HVAC completed their trims.
The electricians worked on the trims and light fixture installation.
The low-voltage contractor completed the majority of their cable pulling in the conduits.
The curb was poured in front of the school, and the grader worked on the grading around it for the next phase of curbing.
Upcoming:
The siding will continue.
The elevator installation will continue.
The electrical work will continue with trims, meter panels, and service work.
The interior door installation will begin.
